Darlington licence renewal update

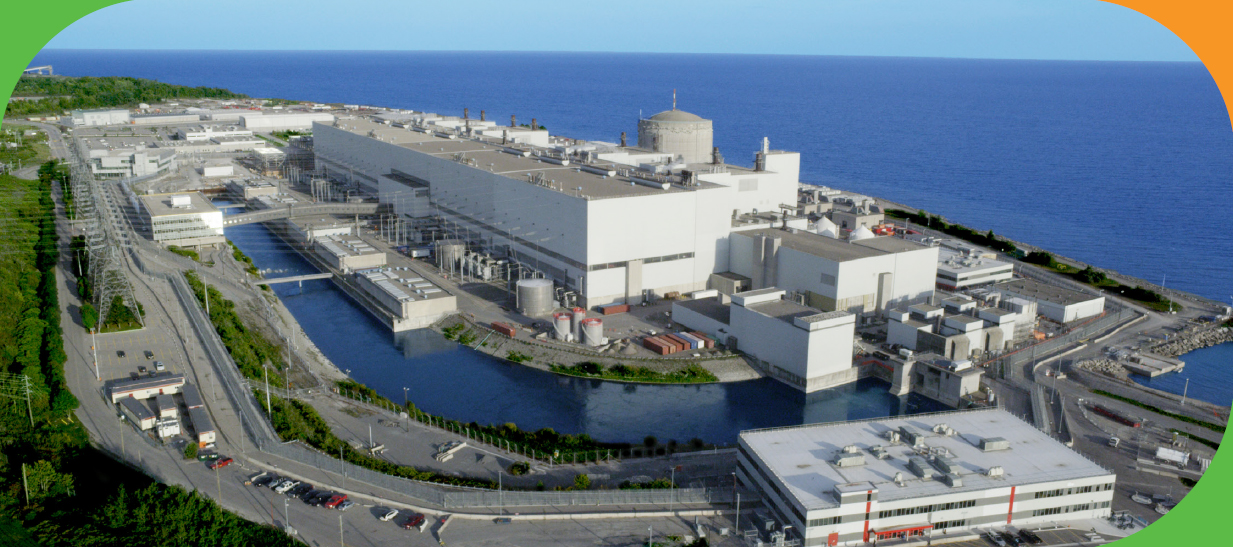

Aerial photo of the Darlington Nuclear Generating Station
Aerial photo of the Darlington Nuclear Generating Station

Earlier this year, the Canadian Nuclear Safety Commission (CNSC) held a two-part public hearing to consider OPG’s application to renew the Power Reactor Operating Licence for the Darlington Nuclear Generating Station for a 30-year term.

During part two of the hearing in June, Indigenous Nations and communities, stakeholders, community groups, and the public had the opportunity to comment on OPG’s application through written interventions and oral presentations.

OPG has safely and reliably operated nuclear stations for more than 50 years. The Darlington station provides clean baseload power that is critical to meeting Ontario’s growing energy needs. The station is currently undergoing a multi-year refurbishment to safely extend operations. To learn more about the Refurbishment project visit opg.com/darlingtonrefurb.

A decision from the Commission is expected this fall.

For more information, including recordings of the public hearings, visit the CNSC website at www.cnsc-ccsn.gc.ca. Additional information is also available on our Operating Licences page.

OPG seeks licence renewal at Pickering

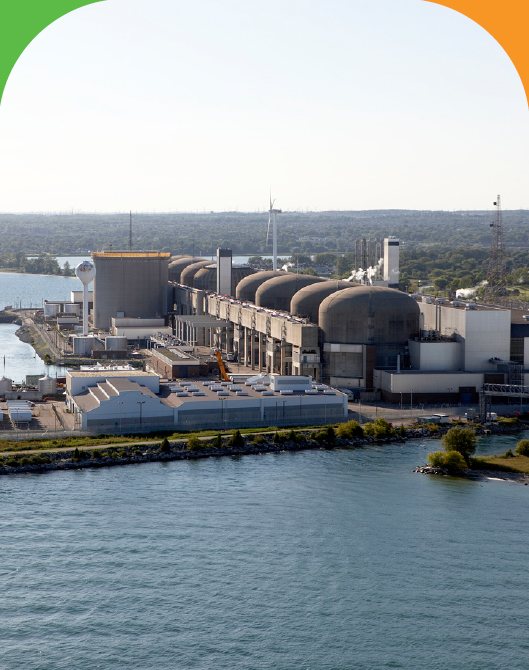

Aerial photo of the Pickering Nuclear Generating Station
Aerial photo of the Pickering Nuclear Generating Station

In June, OPG submitted an application to the CNSC for early renewal of both the Pickering Nuclear Generating Station (NGS) Power Reactor Operating Licence (PROL) and the Pickering Waste Facility Operating Licence (WFOL) for a 10-year term from Jan. 1, 2027 to Dec. 31, 2036. The CNSC will hold a 2-part public hearing on April 1, 2026, and the week of June 22, 2026 to consider OPG’s application.

Both licences are valid until Aug. 31, 2028, with authorization for Units 5 to 8 to operate until Dec. 31, 2026, up to a maximum of 305,000 equivalent full power hours.

We will continue to put our communities first. Refurbishing the Pickering NGS will provide many benefits to customers, the economy, and the environment and secure more than 2,100 MW of clean, reliable power for more than 30 years, ensuring a stable energy supply for Ontarians.

Accent: sxfgaojncey2
Kenetic_05
Minister of Energy and Mines visits the Darlington New Nuclear Project site
Minister of Energy and Mines visits the Darlington New Nuclear Project site

Ontario green lights North America’s first grid-scale SMR

In early May, the Province of Ontario approved OPG to begin construction of North America’s first commercial, grid-scale Small Modular Reactor (SMR) at the Darlington New Nuclear Project (DNNP) site.

Through the DNNP, OPG plans to construct and operate four grid-scale BWRX-300 SMRs (pending regulatory approvals). The first unit, scheduled to come online by the end of 2030, is expected to deliver 300 megawatts (MW) of safe, reliable, low-carbon electricity — enough to power approximately 300,000 homes.

This historic project marks the province’s first new nuclear build in over 30 years. Once complete, OPG’s SMR fleet will contribute significantly to local, provincial and national economies, support Ontario’s growing electricity needs and shine an international spotlight on the Canadian nuclear supply chain.

Harriet Brooks arrives at the DNNP site

Harriet Brooks and OPG’s Tunning Boring Machine
Harriet Brooks and OPG’s Tunnel Boring Machine

OPG’s Tunnel Boring Machine (TBM) - named Harriet Brooks after Canada’s first female nuclear physicist - has successfully arrived on Canadian soil.

After travelling from the Netherlands, then making its way from the Port of Oshawa through 15 carefully coordinated shipments, this critical piece of equipment is now ready and available for assembly at the project site in early 2026.

Once operational, the TBM will bore and line the 3.4 kilometre-long Condenser Cooling Water tunnel—an essential element for bringing OPG’s SMR fleet online.

DNNP Chronology

Project Status: UnderwayStart Date: 2006Expected Completion: TBD

Click on 🛈 below to read more information on milestones and related documents.

2006
May 2006
Ontario directs OPG to initiate the federal approvals
DNNP Chronology
May 2006
Ontario directs OPG to initiate the federal approvals
  • The Government of Ontario, OPG’s shareholder, directs OPG to initiate the federal approvals process for new nuclear generating units in response to recommendations from the Ontario Power Authority’s Integrated Power System Plan.
  • The Plan calls for investment in new nuclear generation capacity in order to maintain Ontario’s nuclear generating capacity at 14000 MWe, consistent with nuclear energy’s share of the 2005 supply mix.
2006-2009
OPG conducts Environmental Assessment
DNNP Chronology
2006-2009
OPG conducts Environmental Assessment
  • As required by the Canadian Environmental Assessment Act (1992), an Environmental Assessment (EA) of the proposed project is conducted, including comprehensive studies undertaken by OPG and consultation with Indigenous communities, local community members and the broader public.
September 2009
OPG submits Environmental Impact Statement
DNNP Chronology
September 2009
OPG submits Environmental Impact Statement
March 2011
Joint Review Panel conducts public hearing
DNNP Chronology
March 2011
Joint Review Panel conducts public hearing
August 2011
Joint Review Panel submits EA report
DNNP Chronology
August 2011
Joint Review Panel submits EA report
May 2012
Government of Canada accepts Joint Review Panel recommendation
DNNP Chronology
May 2012
Government of Canada accepts Joint Review Panel recommendation
  • The Government of Canada issues a response accepting the recommendation of the Joint Review Panel and accepting the Environmental Assessment (EA).
August 2012
CNSC issues licence to prepare site
DNNP Chronology
August 2012
CNSC issues licence to prepare site
  • The CNSC issues the Licence to Prepare Site to OPG for a period of 10 years, valid from August 17, 2012 to August 17, 2022.
December 2013
Ontario asks OPG to defer construction but maintain site licence
DNNP Chronology
December 2013
Ontario asks OPG to defer construction but maintain site licence
  • Citing lower than planned power consumption growth combined with a strong supply situation, the Government of Ontario, through the 2013 Long-Term Energy Plan, requests that OPG defer the construction of new nuclear reactors but maintain the existing licence.
2013 to Today
OPG maintains site licence
DNNP Chronology
2013 to Today
OPG maintains site licence
  • OPG continues to maintain the licence in accordance with the licence conditions.
September 2018
OPG submits mid-term report
DNNP Chronology
September 2018
OPG submits mid-term report
  • OPG submits a licence Mid-Term report to the CNSC, outlining the activities undertaken since the licence was granted as well as a report providing an update on the commitments made by OPG (updated April 2019) during the licencing process.
September 2018
OPG notifies CNSC of intent to apply for licence renewal
DNNP Chronology
September 2018
OPG notifies CNSC of intent to apply for licence renewal
  • OPG issues notification to the CNSC of our intent to apply to renew the site licence that is set to expire in August 2022.
October 2019
OPG submits site preparation licence renewal plan
DNNP Chronology
October 2019
OPG submits site preparation licence renewal plan
June 2020
OPG submits application to renew licence for Darlington New Nuclear
DNNP Chronology
June 2020
OPG submits application to renew licence for Darlington New Nuclear

OPG has submitted an application to the Canadian Nuclear Safety Commission (CNSC) seeking renewal of the licence that allows OPG to undertake site preparation activities required for new nuclear generation at OPG’s Darlington site.

OPG currently holds a Site Preparation Licence for the Darlington Nuclear site, the first of a series of licences that would be required for additional nuclear generation capacity. The current 10-year licence was obtained following the completion of comprehensive environmental impact studies and an extensive public hearing conducted by a Joint Review Panel of the CNSC and the Canadian Environmental Assessment Agency in 2012.

OPG has not yet undertaken any licenced activities on the site. However, the existing licence allows OPG to carry out activities to prepare the site for future construction, for example:

  • Clearing and grubbing vegetation
  • Excavation and grading of site
  • Installing services and utilities required to service the future project facilities (e.g., domestic water, fire water, sewage, electrical, communications, natural gas)
  • Constructing support buildings

As the licence expires in 2022, renewing the licence will help maintain the option for reliable, low carbon nuclear energy to remain a key part of Ontario’s low-emission energy mix.

With the application submitted, the CNSC will determine the timing and process for review. A decision by the commission members is expected in 2021. The application and supporting documents are available here:

October 2020
CNSC announces public hearing dates and availability of participant funding
DNNP Chronology
October 2020
CNSC announces public hearing dates and availability of participant funding
November 2020
OPG resumes planning activities for Darlington New Nuclear
DNNP Chronology
November 2020
OPG resumes planning activities for Darlington New Nuclear
  • On Nov. 13, 2020, OPG was joined by Provincial government and local municipal and business leaders to announce that planning activities will resume to construct a Small Modular Reactor at OPG’s Darlington site in Clarington.
June 2021
CNSC Site Preparation Licence renewal hearing
DNNP Chronology
June 2021
CNSC Site Preparation Licence renewal hearing
October 2021
CNSC approves renewal of licence to prepare site
DNNP Chronology
October 2021
CNSC approves renewal of licence to prepare site
  • The CNSC issued the Licence to Prepare Site renewal to OPG for a period of 10 years, valid from October 12, 2021 until October 11, 2031.
December 2021
OPG announces partnership with SMR technology developer GE Hitachi Nuclear Energy
DNNP Chronology
December 2021
OPG announces partnership with SMR technology developer GE Hitachi Nuclear Energy

On Dec. 2, 2021, OPG was joined by the Minister of Energy, and local elected officials and business leaders to announce it will work together with GE Hitachi Nuclear Energy to deploy a Small Modular Reactor (SMR) at the Darlington new nuclear site, the only site in Canada currently licenced for a new nuclear build.

March 2022
OPG announces partnership with E.S. Fox Limited for execution of early site preparation activities
DNNP Chronology
March 2022
OPG announces partnership with E.S. Fox Limited for execution of early site preparation activities

On Mar. 10, 2022, OPG was joined by the Minister of Energy and local elected officials and business leaders to announce a contract award to E.S. Fox to perform the early site preparation work required for future construction of the company’s first grid-scale small modular reactor.

June 2022
CNSC approves Financial Guarantee for Site Preparation phase of the Darlington New Nuclear Project
DNNP Chronology
June 2022
CNSC approves Financial Guarantee for Site Preparation phase of the Darlington New Nuclear Project

On June 8, 2022 the Canadian Nuclear Safety Commission announced its approval of OPG’s application for acceptance of the Financial Guarantee for the site preparation phase of the Darlington New Nuclear Project. This milestone opens the door for site preparation work to begin.

September 2022
OPG begins site preparation activities at Darlington site
DNNP Chronology
September 2022
OPG begins site preparation activities at Darlington site

OPG has received regulatory approval to enter into the next phase of project development – site preparation.

This work includes non-nuclear infrastructure activities, such as clearing and grading a portion of the new nuclear site to build roads, utilities and support buildings. Mobilization for these activities begins in late September 2022, with execution of site preparation work planned to continue into 2025.

October 2022
OPG applies to the CNSC for a Licence to Construct
DNNP Chronology
October 2022
OPG applies to the CNSC for a Licence to Construct

A Licence to Construct from the CNSC is required before any construction work on an SMR at Darlington can begin. OPG’s application for this licence is comprised of a number of packages, submitted to the CNSC over the course of several months. This application process will culminate in a public hearing where the regulator will hear comments from members of the public regarding our application.

January 2023
Team forms to build North America’s first SMR
DNNP Chronology
January 2023
Team forms to build North America’s first SMR

OPG partnered with GE Hitachi Nuclear Energy (GEH), SNC-Lavalin, and Aecon to plan, construct, and deploy an SMR at the Darlington site.

All parties will manage the project as an integrated team and each company will play a specific role in successfully completing the Darlington New Nuclear Project:

  • OPG: The licence holder; OPG will maintain overall responsibility for the project, including operator training, commissioning, Indigenous engagement, stakeholder outreach and oversight.
  • GE Hitachi: The technology developer; responsible for design, procurement of major components, and engineering and support.
  • SNC-Lavalin: The architect engineer; provides design, engineering and procurement support.
  • Aecon: The constructor; will provide construction planning and execution.
July 2023
Ontario announces planning and licencing for three additional SMRs
DNNP Chronology
July 2023
Ontario announces planning and licencing for three additional SMRs

On July 7, 2023, the Ontario government announced it will work with OPG to commence planning and licencing for three additional SMRs, for a total of four, at the Darlington new nuclear site.

November 2023
OPG selects fuel suppliers for SMR
DNNP Chronology
November 2023
OPG selects fuel suppliers for SMR

Ontario Power Generation (OPG) announced it is partnering with companies from Canada, the U.S., and France to ensure a fuel supply for the first unit of its four-unit Darlington New Nuclear Project.

The four contracts will involve:

  • Canadian company, Cameco, which has uranium mines in Saskatchewan and a Uranium Hexafluoride (UF6) conversion facility in Port Hope, will supply natural UF6.
  • US-based, Urenco USA (UUSA) will provide uranium enrichment services from their operations in Eunice, New Mexico.
  • France’s Orano will provide additional Enriched Uranium Product (EUP) from their operations in France.
  • And US-based, Global Nuclear Fuel-Americas LLC, a GE-led joint venture, will provide fuel fabrication and related technical services and fuel assemblies.
January 2024
CNSC hearing for the Applicability of the DNNP Environmental Assessment and Plant Parameter Envelope to BWRX-300
DNNP Chronology
January 2024
CNSC hearing for the Applicability of the DNNP Environmental Assessment and Plant Parameter Envelope to BWRX-300

The CNSC held a three-day hybrid hearing to consider the applicability of the DNNP environmental assessment and plant parameter envelope to OPG’s selected BWRX-300 small modular reactor technology

February 2024
Early site preparation work complete
DNNP Chronology
February 2024
Early site preparation work complete

On Feb. 15, 2024, OPG and site preparation partner, E.S. Fox, turned the Darlington New Nuclear Site over to construction partner, Aecon, following on-schedule completion of the early site preparation work program. The work completed under the Site Preparation Licence over the past two years included site clearing and grading, construction of temporary roads and laydown areas, and installation of stormwater features, as well as establishing on-site utilities. Aecon will now undertake the main site preparation work program which will include installation of permanent construction power, clearing and grubbing for a four-unit layout, construction work for site establishment activities including the shoring wall required for reactor building excavation, and construction of fabrication and administration buildings.

April 2024
CNSC confirms DNNP existing EA is applicable to BWRX-300 reactor technology
DNNP Chronology
April 2024
CNSC confirms DNNP existing EA is applicable to BWRX-300 reactor technology

On April 22, 2024, the Canadian Nuclear Safety Commission (CNSC) announced the Commission’s decision that the existing environmental assessment for the Darlington New Nuclear Project is applicable to GE Hitachi’s BWRX-300 small modular reactor technology.

October 2024
CNSC hearing on OPG’s application for a Licence to Construct one BWRX-300 reactor (Part 1 of 2)
DNNP Chronology
October 2024
CNSC hearing on OPG’s application for a Licence to Construct one BWRX-300 reactor (Part 1 of 2)

The CNSC held a virtual hearing the first hearing in a set of two on this matter – to consider OPG’s application for a licence to construct one BWRX-300 reactor for its Darlington New Nuclear Project.

January 2025
CNSC hearing on OPG’s application for a Licence to Construct one BWRX-300 reactor (Part 2 of 2)
DNNP Chronology
January 2025
CNSC hearing on OPG’s application for a Licence to Construct one BWRX-300 reactor (Part 2 of 2)

The CNSC held a hybrid public hearing – the second in a set of two on this matter – to consider OPG’s application for a Licence to Construct one BWRX-300 reactor for its Darlington New Nuclear Project.

April 2025
CNSC issues Licence to Construct first SMR
DNNP Chronology
April 2025
CNSC issues Licence to Construct first SMR

On April 4, 2025 the Canadian Nuclear Safety Commission issued OPG a Licence to Construct one BWRX-300 SMR at the Darlington New Nuclear site, allowing nuclear construction work to begin.

May 2025
Province announces approval of SMR construction
DNNP Chronology
May 2025
Province announces approval of SMR construction

On May 8, 2025 the Provincial Minister of Energy and Mines announced approval for OPG to begin construction on the first of four small modular reactors at the Darlington nuclear site.

October 2025
Federal and Provincial governments announce equity investment in DNNP
DNNP Chronology
October 2025
Federal and Provincial governments announce equity investment in DNNP

On Oct. 23, 2025, Prime Minister Carney and Ontario Premier Doug Ford announced an equity commitment agreement to finance the Darlington New Nuclear Project through the Canada Growth Fund Inc. (CGF) and Building Ontario Fund (BOF).

Following this, the DNNP Limited Partnership (LP) was formed to allow OPG to formally enter into the equity partnership and establishing the means by which the committed financing will flow to the project from the CFG and BOF. On Dec. 29, 2025, OPG leased the Darlington SMR land to DNNP LP.

March 2026
CNSC clears DNNP Regulatory Hold Point-1
DNNP Chronology
March 2026
CNSC clears DNNP Regulatory Hold Point-1

Under the Darlington New Nuclear Project’s Licence to Construct, the CNSC requires OPG to provide additional information prior to undertaking specific construction activities to verify compliance with regulatory requirements related to the safety analysis and design of structures, systems and components that are important to safety – these are called Regulatory Hold Points. In March 2026, the CNSC cleared the DNNP’s Regulatory Hold Point 1 (RHP-1) – Installation of the Reactor Building Foundation, authorizing OPG to place the foundation for the reactor building and commence civil construction of the reactor building structure, internal civil structures, and internal reactor building systems and components.

March 2026
OPG applies to the CNSC for a Licence to Operate first SMR
DNNP Chronology
March 2026
OPG applies to the CNSC for a Licence to Operate first SMR

A Licence to Operate from the CNSC is required in order to complete commissioning and safely operate the SMR, once construction activities are complete. OPG’s application for this licence is comprised of a number of packages, submitted to the CNSC over the course of several months. This application process will culminate in a public hearing where the regulator will hear comments from members of the public regarding our application.

Did you know?

The TBM’s namesake, Harriet Brooks, contributed significantly to our understanding of nuclear physics in the early 20th century through her discovery of radioactive transformation and the radioactive gas radon. While her legacy encapsulates her important work, it is also a reminder of the systemic barriers women in the energy sector have and continue to face, and a call to action for diversity, inclusion and representation.

Accent: shibka9760ne
Kenetic_04
An aerial view of OPG’s Wesleyville site in Port Hope, Ontario
An aerial view of OPG’s Wesleyville site in Port Hope, Ontario

Powering Possibilities in Port Hope

To help meet the growing demand for electricity in the province, the Ontario government has asked Ontario Power Generation (OPG) to explore the potential for new nuclear generation at its Wesleyville site. As a first step in this process, OPG has started early engagement with the Municipality of Port Hope and the Williams Treaties First Nations.

Impact Assessment

Major nuclear projects in Canada are subject to an Impact Assessment (IA) led by the Impact Assessment Agency of Canada (IAAC) and the Canadian Nuclear Safety Commission. Later this year, OPG will submit an Initial Project Description (IPD) to the IAAC. The IPD will detail the potential of hosting up to 10,000 megawatts (MW) of nuclear power generation at the Wesleyville site. The IPD submission is the first step in the IA and kicks off a multi-year process to identify and assess potential impacts, mitigation measures, and enhancement to positive impacts of the project.

Get involved and stay in touch

Our outreach and engagement will be ongoing and consistent as more information on the potential for new nuclear at Wesleyville becomes available.

  • Opening soon: our community information centre at 115 Toronto Rd in Port Hope.
  • Contact us at: 905-623-7122, Toll Free: 1-800-461-0034 or via our Contact Us form.
  • Visit opg.com/wesleyville for information on the initiative, next steps in the process and frequently asked questions.
  • Find members of our project team in your community, staffing information booths at events throughout the summer and fall.
  • Participate in community meetings and forums: They will be advertised locally and posted on our website.
Accent: d6fo7txaeclb
Kenetic_right
OPG team during build what you CAN challenge
OPG team during build what you CAN challenge

Can-struction: Building to make a difference

This past spring, OPG partnered with Feed the Need Durham, collecting 244 pounds of food, providing over 1,037 meals for families in need through a collective food drive and creative “Build what you CAN” challenge at Darlington.

Accent: qcyj4io982sr
Kenetic_left

Upcoming Events

15
Dec
Sessions available until June 30, 2026
In person
A child at a desk in a classroom raises his hand to ask a question.
27
Jun
Saturday, June 27
2 to 3:45 p.m.
Delpark Homes Centre
Kinds swimming underwater in a pool.

Subscribe and stay informed

Sign up to receive the latest news, project updates, and event information from OPG.

Lightbox: subscribe_cta
